Busbar insulation testing at PT. Flextronics Technology Indonesia was previously performed manually at up to 1890 VAC, exposing operators to a high risk of electrical hazard. This project automates the Hi-Pot testing process by integrating a Hi-Pot Test Unit (Metrel 3325) with a Mitsubishi FX3U PLC and relay module — sequencing the high-voltage test across six busbar points automatically, and integrating the station into a One Piece Flow assembly line.
PT. Flextronics Technology Indonesia is a PCB assembly manufacturer that continuously pursues process improvement through its Kaizen (Continuous Improvement) culture. One of its production lines assembles industrial busbars, where each process stage is separated by station and parts are moved manually between them using a trolley.
One critical stage in this line is insulation testing using Hi-Pot (High Potential) test, performed manually at up to 1890 VAC. This manual procedure exposed operators to a significant risk of electrical hazard, making it a priority target for improvement.

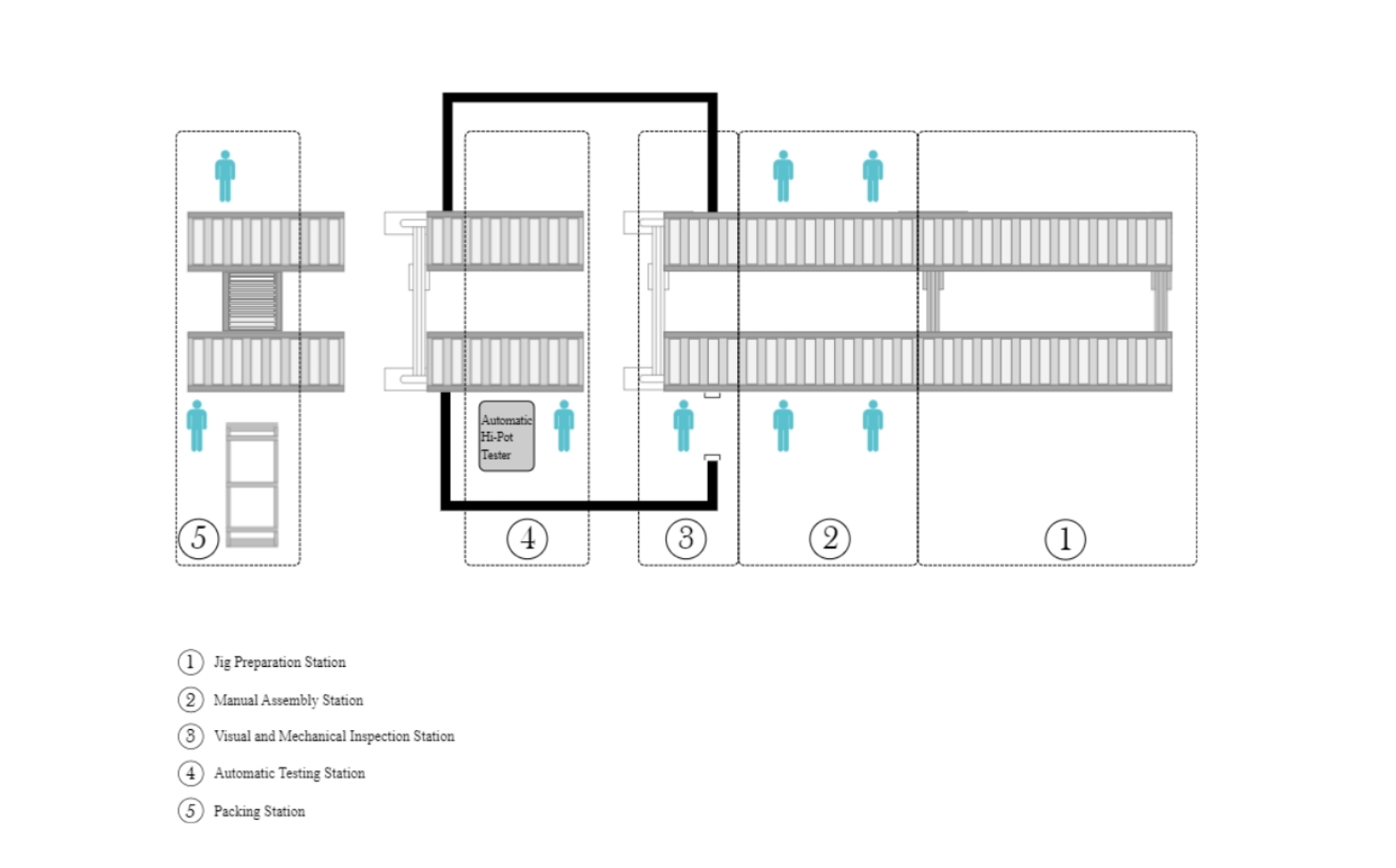

Applying the Kaizen concept, this project redesigns the busbar assembly line into a One Piece Flow production system, where assembly, testing, and packing stations are connected by a single conveyor line, and the Hi-Pot test itself is fully automated through PLC control — removing the operator from direct contact with high voltage.

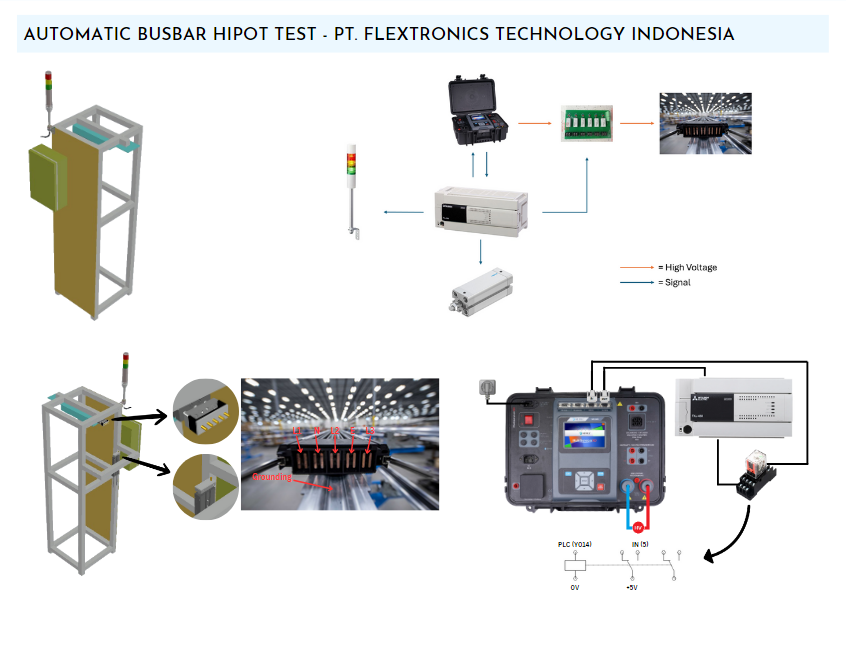

The system integrates three main components: a Hi-Pot Test Unit (Metrel 3325) that generates the high-voltage insulation test, a Mitsubishi FX3U-48 PLC that sequences the entire test cycle, and a 10-channel relay module (HRM24-6A06) that routes the high voltage to six busbar test points across 15 test combinations.
Site visit to the Flex AM line to study the busbar assembly process and identify the manual Hi-Pot test as a safety and efficiency improvement target.
Designing the signal & high-voltage flow between the Hi-Pot Test Unit, PLC, and relay module, along with the relay sequence table for the 15 test combinations.
Wiring the PLC I/O, 10 relay coils, and probe cylinders, then integrating the testing station into the One Piece Flow conveyor layout.
Running the automatic sequence and validating the Pass/Fail signal against known-good and known-fault busbar samples.
| System Specifications | Value |
|---|---|
| Test Voltage (HV AC) | up to 1890 VAC |
| Reject Threshold | > 10 mA |
| Busbar Test Points | 6 points |
| Test Combinations | 15 sequences |
| Sequence Timing (Per sequences) | 4 s |
The system was evaluated first on its impact on operator safety, and then on the accuracy and timing of the automatic Hi-Pot sequence itself, comparing the manual (before) and the automated (after) testing process.
Previously, operators performed the 1890 VAC Hi-Pot test manually with hand-held probes, placing them at direct risk of electrical hazard. After implementation, the probes are positioned automatically by pneumatic cylinders and the test is triggered and read entirely by the PLC — removing the operator from direct contact with high voltage while the machine performs the test automatically.
The automatic Hi-Pot system was tested on twenty busbar samples — ten expected to Pass and ten deliberately fitted with a fault expected to Fail. Every sample was read correctly by the system: a single Fail reading in any of the 15 sequence steps immediately shuts off the HV and returns the mechanism to its home position, while a full Pass reading across all 15 steps is reported as an overall Pass.
| Test Set | Samples | Correct Reading | Result |
|---|---|---|---|
| Good busbar (expected Pass) | 10 | 10 / 10 | All Pass |
| Faulty busbar (expected Fail) | 10 | 10 / 10 | All Fail, HV auto cut-off |
| Overall accuracy | 20 | 20 / 20 | 100% |
Each of the 15 test conditions is held for 4 s, so a complete 15-step sequence takes 60 s (1 minute). Including probe positioning and retraction, one full testing cycle takes approximately 152 s. Pass results turn on the green indicator lamp, while a Fail immediately cuts the HV signal, lights the red lamp, and holds it until the emergency button is pressed.
Full sequence-by-sequence data for all 20 trials — each row shows the reading of every one of the 15 test combinations. A dash (–) marks a step that was not reached because the sequence was already halted by an earlier Fail.
| No | Sequence Pengecekan | Hasil | ||||||||||||||
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| 1 | 2 | 3 | 4 | 5 | 6 | 7 | 8 | 9 | 10 | 11 | 12 | 13 | 14 | 15 | ||
| 1 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass |
| 2 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass |
| 3 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass |
| 4 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass |
| 5 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass |
| 6 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass |
| 7 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass |
| 8 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass |
| 9 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass |
| 10 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Pass |
| 1 | Pass | Pass | Pass | Fail | - | - | - | - | - | - | - | - | - | - | - | Fail |
| 2 | Pass | Pass | Fail | - | - | - | - | - | - | - | - | - | - | - | - | Fail |
| 3 | Pass | Pass | Fail | - | - | - | - | - | - | - | - | - | - | - | - | Fail |
| 4 | Pass | Pass | Pass | Pass | Fail | - | - | - | - | - | - | - | - | - | - | Fail |
| 5 | Pass | Pass | Pass | Pass | Pass | Pass | Fail | - | - | - | - | - | - | - | - | Fail |
| 6 | Pass | Pass | Pass | Pass | Fail | - | - | - | - | - | - | - | - | - | - | Fail |
| 7 | Pass | Pass | Pass | Pass | Pass | Pass | Fail | - | - | - | - | - | - | - | - | Fail |
| 8 | Pass | Pass | Pass | Pass | Pass | Pass | Fail | - | - | - | - | - | - | - | - | Fail |
| 9 | Pass | Fail | - | - | - | - | - | - | - | - | - | - | - | - | - | Fail |
| 10 | Pass | Pass | Pass | Pass | Pass | Pass | Pass | Fail | - | - | - | - | - | - | - | Fail |
The Automatic Hi-Pot Testing Machine successfully runs the full insulation test cycle under PLC control, completing each 15-step sequence in 60 seconds and a full test cycle in approximately 152 seconds, with the Hi-Pot Test Unit reporting Pass/Fail results in real time through the tower lamp indicators.
Across 20 validation trials, the system achieved 100% reading accuracy, and by automating probe placement and HV control, the project removed the operator from direct exposure to the 1890 VAC test — directly addressing the electrical safety issue that motivated the project, while integrating the station into a One Piece Flow busbar assembly line.
